ThingConnect

Machine utilization

Is your utilization really 70%?

Most plants believe a utilization number that came from an assumption. ThingConnect measures it from the controller — when each machine actually ran, for how long, on what — so capacity and capex decisions rest on facts.

In-cycle vs. scheduled vs. idle machine × hour heatmap worst-first ranking

Machine × hour · in-cycle %

One shift, every machine, hour by hour — a ranked table can't show a pattern like a schedule dip; a heatmap can.

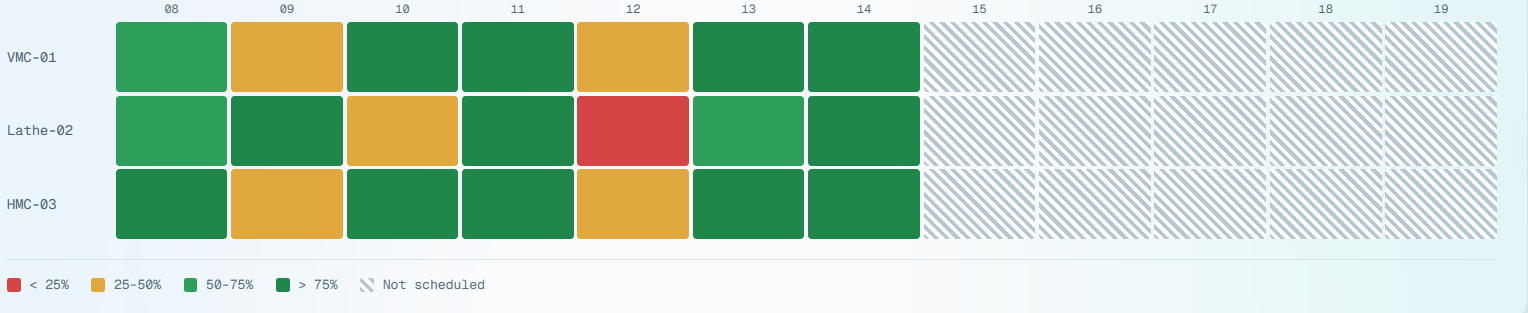

Machine by hour in-cycle heatmap for one shift. Rows VMC-01, Lathe-02 and HMC-03 against hours 08 to 19. Hours 08 to 14 are worked and 15 to 19 are hatched as not scheduled. Most worked cells are above 75%, with 25-50% cells at 09 and 12 on VMC-01, at 10 on Lathe-02 and at 09 and 12 on HMC-03, and one under-25% cell at 12 on Lathe-02 — 12:00 is the coldest column across all three machines.Tap to zoom
Cold column: 12:00 runs coldest across the fleet — that's schedule shape, not machine health.

The problem

Decisions being made on assumed numbers

  • A new machine gets approved while three existing ones sit idle 30% of the day — invisibly.
  • Quotes assume capacity that the floor doesn't actually have.
  • 'We're running flat out' and 'the machines are half idle' are both said in the same meeting.
  • Second-shift viability is debated on gut feel because nobody trusts the utilization sheet.

How it works

Measured from the control, not assumed

Measured, not assumed

Utilization is computed from controller run state against calendar or shift time — your choice of denominator, stated on every report.

Per machine, per cell, per week

Rank machines by utilization, spot the chronically idle ones, and see patterns by shift and day of week.

The capex conversation, settled

When someone proposes buying capacity, the utilization report shows whether you already own it. This report pays for the system.

What the report shows

From one calendar split to an hourly trend

The same real breakdown of calendar time — not scheduled, idle, in-cycle — read one way as four numbers, and another way as a hour-by-hour line against a goal.

Every hour is one of three things

Not scheduled, idle, or in-cycle — a strict breakdown of calendar time, not four independent numbers someone has to reconcile by hand. Idle isn’t a separate query either: it’s scheduled hours minus in-cycle time, the same idle concept the downtime report already classifies in full.

KPI strip · this shift

In-cycle

65.9%

of 21h scheduled machine-hours

Scheduled

21h

of 36h in the production window

Not scheduled

15h

the TEEP gap — vs. the whole shift plan

Idle

7.2h

scheduled, but not cutting

In-cycle %, hour by hour, against a goal

The fleet average from the heatmap above, replotted as a trend against a goal line — the only comparison this report supports, because there’s no industry benchmark worth trusting, only your own plan.

↑ See the full machine × hour heatmap above
Utilization trend

In-cycle %, one point per hour, this shift.

0%25%50%75%100%08:0009:0010:0011:0012:0013:0014:00
  • In-cycle % · fleet average
  • 80% goal

Per machine

Worst in-cycle % first

The same ranking discipline as every other report on this site — not sortable by column, so a ranking exists to be acted on, not silently re-ordered.

Per machine · this shift

Machine, in-cycle %, idle, stops, good parts — no 'Control' column, since no controller/model field exists anywhere in this app.

MachineIn-cycle %IdleStopsGood parts
Lathe-0261.3%2.7h8410
VMC-0166.4%2.3h5560
HMC-0370%2.1h3640

Questions

Before you book a demo

Utilization asks 'was the machine running?' against total available time; OEE also weighs speed and quality while running. ThingConnect reports both, clearly labeled, because mixing them up is the most common measurement mistake we see.

Your choice, and both can be shown. Calendar-time utilization (TEEP-style) exposes unused capacity; shift-time utilization measures how well staffed time is used.

Yes — per machine, group, line, or plant, across any date range, exportable to Excel.

As accurate as the control's own state reporting, which is what the machine itself believes. Machines without a connectable control are flagged in the site survey rather than guessed at.

Get started

See your real utilization number

A 30-minute demo, then a pilot on your own floor if it fits.
